Fiberglass pool installation Winnipeg Azoria shell placement with patio surround and landscape integration

Fiberglass Pool Installation Winnipeg: Cost & Timeline

Fiberglass Pool Installation Winnipeg: Cost, Timeline and Why Zone 3 Homeowners Choose Fiberglass
Quick Takeaways
  • Lawn ‘N’ Order partners with Azoria, Canada’s largest fiberglass pool manufacturer, to install pools designed and engineered for Canadian winters
  • Fiberglass pools install in days, not months: the shell arrives pre-built and goes into a prepared excavation, compared to the multi-month timeline of a poured concrete pool
  • Fiberglass flexes with frost movement instead of cracking; concrete pools are more prone to structural cracking from Winnipeg’s freeze-thaw cycle
  • A fiberglass pool installation should never be fully drained for winter; proper winterization involves lowering the water level, not emptying the pool
  • Full project cost includes the pool shell, excavation and base preparation, plumbing and equipment, and the surrounding landscape: patio, privacy screening, lighting, and any outdoor living elements

Lawn ‘N’ Order and Azoria: Our Role in the Project

Lawn ‘N’ Order works with Azoria, the manufacturer behind the pool shells we install, to bring fiberglass pools to Winnipeg properties. Azoria designs and manufactures the fiberglass shell in a controlled factory environment, engineered specifically for Canadian climate conditions. Lawn ‘N’ Order handles everything that happens on your property: site assessment, excavation, base preparation, the pool installation itself, plumbing and equipment connection, and the surrounding landscape design that turns a pool shell into a finished backyard.

This reflects how fiberglass pool projects generally work across Canada: the manufacturer builds the shell to a consistent engineering standard, and a local, experienced installer handles the site-specific work that determines how well that shell performs once it is in the ground. For a Winnipeg property, the site-specific work — frost depth, soil type, drainage, and seasonal planning — is where 30-plus years of local landscaping experience makes the difference between a pool that performs for decades and one that develops problems within a few seasons.

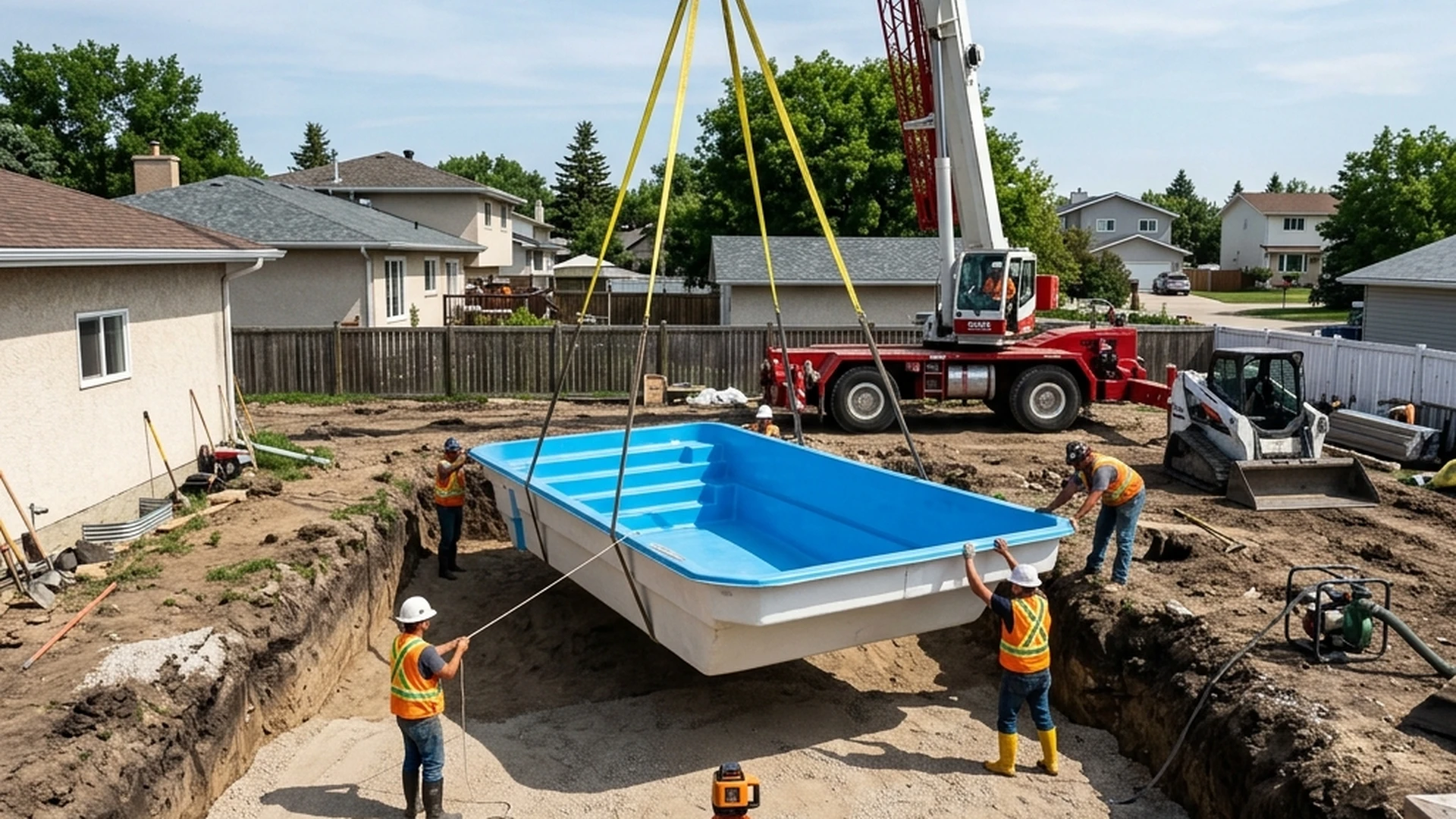

Fiberglass pool shell being lowered into prepared excavation in Winnipeg backyard during Azoria installation
The Azoria fiberglass shell arriving at a Winnipeg property: manufactured in a controlled factory environment and engineered for Canadian climate conditions. The shell goes into a prepared excavation in a single day, with plumbing and equipment connection following over the next few days.

Why Fiberglass Performs Differently Than Concrete or Vinyl in Winnipeg’s Climate

Winnipeg’s frost depth reaches approximately 4 feet, and the ground goes through dozens of freeze-thaw cycles each year. Any structure buried in that ground experiences real seasonal movement. How each pool type responds to that movement is the central technical difference between fiberglass, concrete, and vinyl liner construction.

Fiberglass: Flexes With Ground Movement

A fiberglass pool shell is manufactured as a single flexible composite structure. When frost causes soil movement around the shell, the fiberglass flexes slightly rather than resisting the pressure rigidly. This flexibility is the core reason fiberglass pools have become the preferred option in cold-climate markets across Canada and the northern United States: the material absorbs seasonal ground movement instead of cracking under it. Properly installed on a compacted gravel base with adequate perimeter drainage, a fiberglass shell maintains its structural integrity through Winnipeg winters without the resurfacing or structural crack repair that concrete pools commonly require.

Concrete: Strong but Rigid

Concrete (gunite or shotcrete) pools are extremely strong in compression but lack the flexibility to absorb ground movement. As frost shifts the soil around a concrete shell, the rigid structure can develop hairline cracks in the plaster surface over time, and in more significant cases, structural cracking that requires expensive repair. Concrete pools also typically need resurfacing every 10 to 15 years and more frequent acid washing to manage algae growth on the porous plaster surface.

Vinyl Liner: Budget-Friendly, More Liner Maintenance

Vinyl liner pools use a flexible wall structure that tolerates some ground movement reasonably well, but the vinyl liner itself is a thinner, softer material than fiberglass gelcoat or concrete plaster. Liners typically require replacement every 7 to 10 years, and cold temperatures make vinyl more prone to brittleness and tearing if not winterized correctly.

Side-by-Side Comparison

Fiberglass vs Concrete vs Vinyl Liner — Winnipeg Climate Performance
FactorFiberglassConcreteVinyl Liner
Installation timelineDays to a few weeks2 to 3 months3 to 4 weeks
Freeze-thaw performanceFlexes with ground movementProne to crackingTolerates movement; liner is the weak point
Surface maintenanceNon-porous gelcoat, minimalResurfacing every 10 to 15 yearsLiner replacement every 7 to 10 years
Winter requirementLower water level only; never fully drainHigher alkalinity managementLower water level, careful liner inspection
CustomizationDefined shapes from manufacturer lineUnlimited custom shapesFlexible sizing, liner pattern options

Installation Timeline: What to Expect

One of the most significant practical advantages of a fiberglass pool is project duration. Because the shell arrives pre-manufactured rather than being built on site, the on-property timeline is measured in days rather than months.

Site assessment and design consultation: 1 to 2 weeks (scheduling and planning, not on-site work)

Excavation, base preparation, and backfill: 1 to 3 days depending on site access and soil conditions

Pool shell placement: 1 day

Plumbing, electrical, and equipment installation: 2 to 5 days

Surrounding landscape, patio, and finishing work: 1 to 4 weeks depending on scope

The pool itself can be swimmable within two to four weeks of excavation starting. The surrounding landscape work — patio surfaces, privacy screening, lighting, and any additional outdoor living features — is typically the longer phase of the overall project.

Completed fiberglass pool in Winnipeg backyard with interlocking paver patio surround and landscaping integration
A completed fiberglass pool installation in a Winnipeg backyard, with interlocking paver patio surround, privacy fence, and landscape integration. The pool shell installation takes days; the surrounding outdoor living space is the larger project timeline.

Cost of Fiberglass Pool Installation in Winnipeg

Total project cost depends heavily on pool size, site conditions, and the scope of surrounding landscape work. A complete pool package typically lands in the $50,000 to $130,000 range, depending on pool size, features, and the scope of surrounding landscape work. Projects with extensive landscape integration, a fully designed outdoor living space built around the pool, sit toward the upper end.

ComponentTypical Range
Pool shell (size and model dependent)$30,000 to $60,000+
Excavation, base preparation, and backfill$8,000 to $20,000 depending on access and soil conditions
Plumbing, filtration, and equipment$8,000 to $18,000
Basic surrounding patio and coping$10,000 to $25,000 depending on materials and area
Full landscape integration (privacy screening, lighting, outdoor living)$15,000 to $50,000+ depending on scope

Use the Lawn ‘N’ Order cost calculator to begin scoping your specific project, or book a site consultation for a detailed quote.


Landscape Integration: The Part That Makes the Pool Work

A pool shell in the ground is the start of the project, not the finish. The surrounding landscape design is what determines whether the pool functions well for the way you actually want to use the backyard.

Patio Surround

The deck or patio surface around the pool needs to handle wet feet, provide adequate slip resistance, and tolerate Winnipeg’s freeze-thaw cycle without heaving or cracking. Interlocking pavers, natural stone, and properly reinforced concrete are the common choices, each with different cost, maintenance, and aesthetic profiles.

Privacy Screening

Most homeowners installing a pool want some degree of privacy from neighbouring properties. This typically combines fencing (often required by Winnipeg bylaw around pools regardless of privacy preference) with strategic planting: cedar hedges, ornamental grasses, or other Zone 3-appropriate screening that integrates the pool area into the broader landscape rather than leaving it as an isolated feature. See our privacy landscaping guide for screening options suited to Winnipeg’s climate.

Lighting

Pool area lighting extends usable hours into the evening and is a meaningful design and safety consideration. Underwater pool lighting, deck-level path lighting, and feature lighting on surrounding landscape elements are typically planned together as part of the full project design.

Manitoba Pool Bylaw and Fencing Requirements

The City of Winnipeg requires fencing around residential pools to specific height and gate specifications intended to prevent unsupervised access. Requirements address fence height, gate self-closing and self-latching mechanisms, and in some cases pool alarms or covers. Confirm current bylaw requirements with the City of Winnipeg before finalizing pool placement and fence design, as these requirements affect where the pool can be positioned on the property and what the surrounding fence design needs to include.

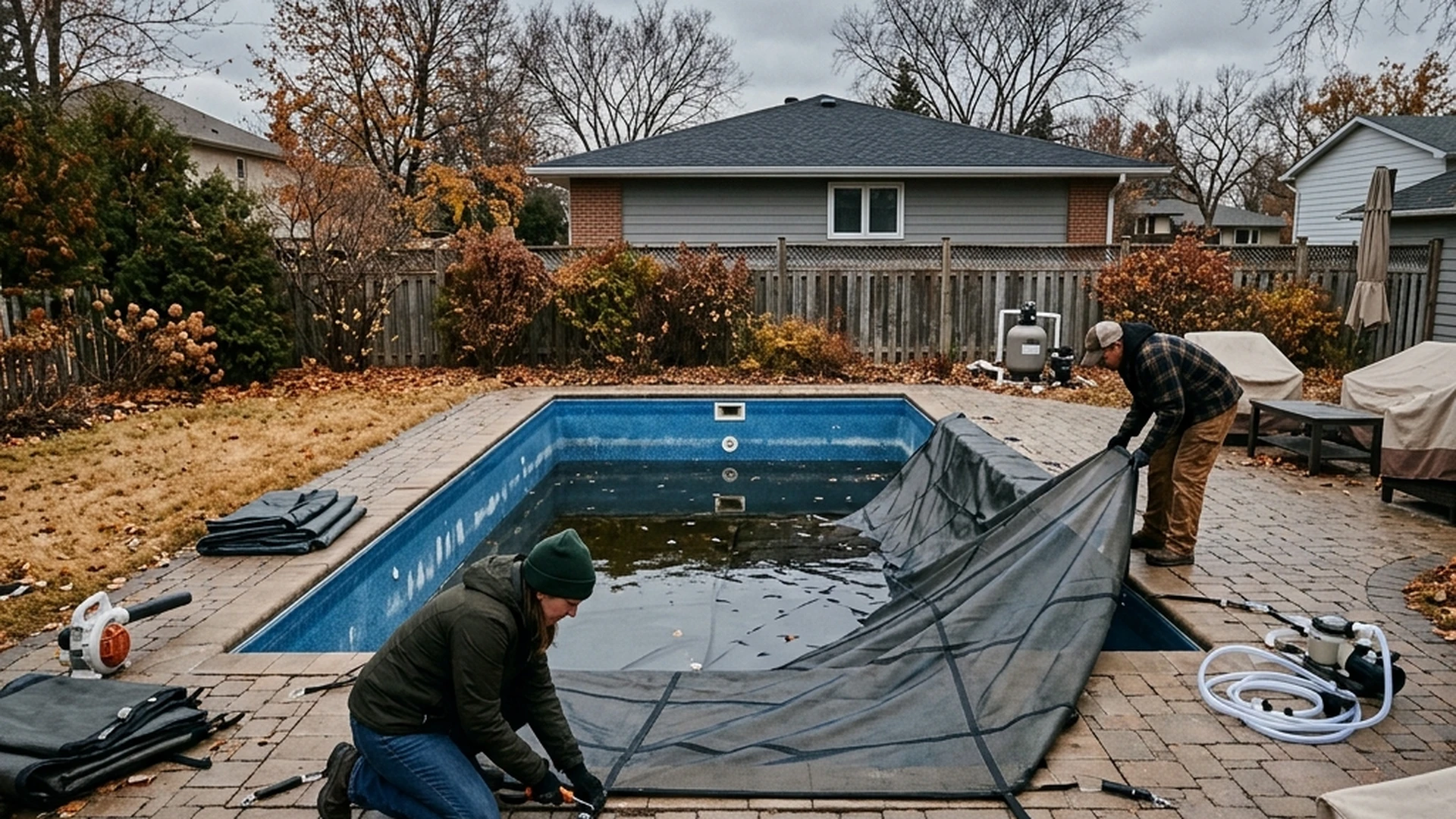

Fiberglass pool winterization in Winnipeg showing water level lowered below skimmer with pool cover for freeze season
Fiberglass pool winterization: the water level is lowered below the skimmer, water chemistry is balanced, and plumbing and equipment are winterized. The shell itself stays full of water. Draining a fiberglass pool — in winter or any other time — removes the water weight that helps hold it stable in the ground.

FAQ: Fiberglass Pool Installation in Winnipeg

Do I need to drain my fiberglass pool for winter?

No. A fiberglass pool should never be fully drained, in winter or at any other time. Draining the shell removes the water weight that helps hold it stable in the ground and can compromise both the shell and the surrounding installation. Winterizing a fiberglass pool involves lowering the water level below the skimmer, balancing water chemistry, winterizing the plumbing and equipment to prevent freeze damage, and covering the pool. The shell itself stays full.

How long does the whole project take from start to finish?

The pool shell installation itself, from excavation to a swimmable pool, typically takes two to four weeks once work begins on site. The full project timeline including design consultation, permitting, and the surrounding landscape build is longer, often 6 to 12 weeks total depending on the scope of the landscape work and the time of year. Booking early in the season improves scheduling flexibility for a pool you want ready for summer.

Can a fiberglass pool be installed on a sloped or clay-heavy lot?

Yes, with appropriate site preparation. Winnipeg’s clay soil and varying lot grades are factored into the excavation and base design for every installation. Proper base preparation, drainage planning, and grading around the finished pool are standard parts of the process specifically because Winnipeg sites require this attention. A site assessment before the project begins identifies what specific preparation your property needs.
